Indonesia – Disinfectants & Biocides – Biocide Authorization

Simplified Roadmap

QMS-SR-RA-BPOM-biocide-authorization

Version: 08/20/2025

Prepared by: Dr. Vlad Reznikov

Date: August 19, 2025


Executive Summary

This roadmap describes Biocide Authorization in Indonesia for the Disinfectants & Biocides category. Consider market size, population, GDP and PPP when prioritizing launch order—see GDP Matrix (ROCKSTARS, HONEYBEES, MAVERICKS, UNDERDOGS): https://patternofusa.com/gdpmatrix/. Peer markets with similar frameworks may allow reliance or abridgement where eligible.

Key Regulations & Requirements

National Regulatory Authority (NRA): BPOM

Documents / Standards / Certifications:

  • Active substance status
  • Efficacy data (EN)
  • Toxicology/exposure
  • Labeling & hazard comms
  • Environmental risk assessment

Notes: Submission format, portal, legalization, and language for Indonesia require verification .

Estimated Timeline

Zero‑based Gantt timeline (weeks). Bars are illustrative; adjust per project scope.

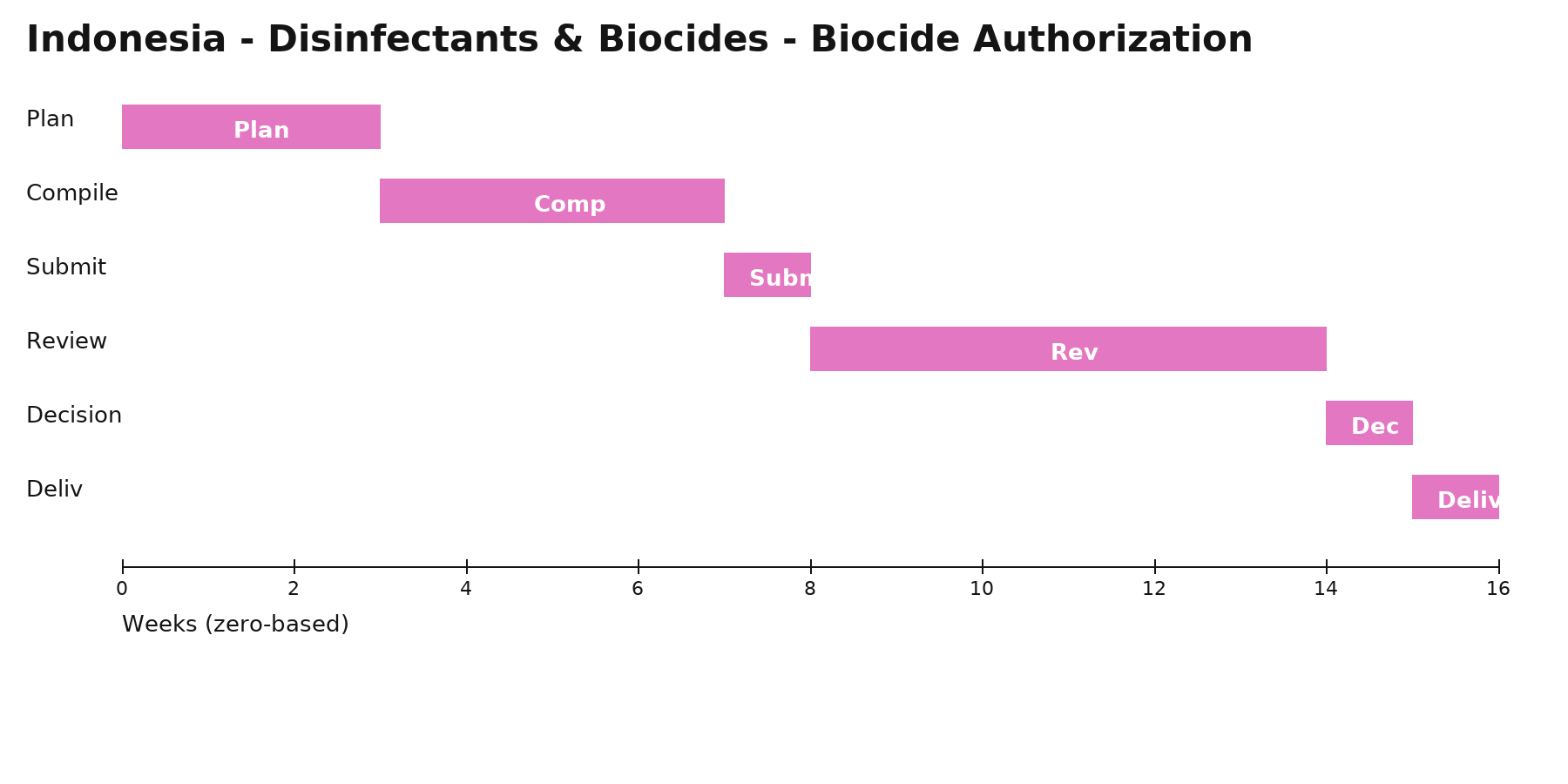

Gantt timeline

Phases & Tasks

Plan (3 wks) — Define pathway, reliance, local roles (MAH/agent); build high-level plan & risk register.

Compile (4 wks) — Assemble dossier/quality evidence; confirm translations, legalization/apostille, and samples/testing.

Submit (1 wk) — File via portal/gateway; complete fee payment and resolve validation issues.

Review (6 wks) — Manage queries/clock-stops; submit clarifications, addenda, or product samples as requested.

Decision (1 wk) — Receive authorization or additional requests; align launch, PV, and supply readiness.

Deliv (1 wk) — Issue internal release pack (certificates, approved labels, SOPs) and plan for renewals/variations.

Deliverables

  • Authorization/Certificate or Registration Record
  • Approved labeling/artwork (as applicable)
  • Final dossier, correspondence log, and post‑approval plan
