Canada – Vet & Animal Health – New Animal Drug Authorization

Simplified Roadmap

QMS-SR-RA-HC-new-animal-drug-authoriz

Version: 08/20/2025

Prepared by: Dr. Vlad Reznikov

Date: August 19, 2025


Executive Summary

This roadmap describes New Animal Drug Authorization in Canada for the Vet & Animal Health category. Consider market size, population, GDP and PPP when prioritizing launch order—see GDP Matrix (ROCKSTARS, HONEYBEES, MAVERICKS, UNDERDOGS): https://patternofusa.com/gdpmatrix/. Peer markets with similar frameworks may allow reliance or abridgement where eligible.

Key Regulations & Requirements

National Regulatory Authority (NRA): HC

Documents / Standards / Certifications:

  • Quality dossier
  • Target animal safety/efficacy
  • Residue & environmental studies
  • Labeling
  • Site GMP evidence

Notes: Submission format, portal, legalization, and language for Canada require verification .

Estimated Timeline

Zero‑based Gantt timeline (weeks). Bars are illustrative; adjust per project scope.

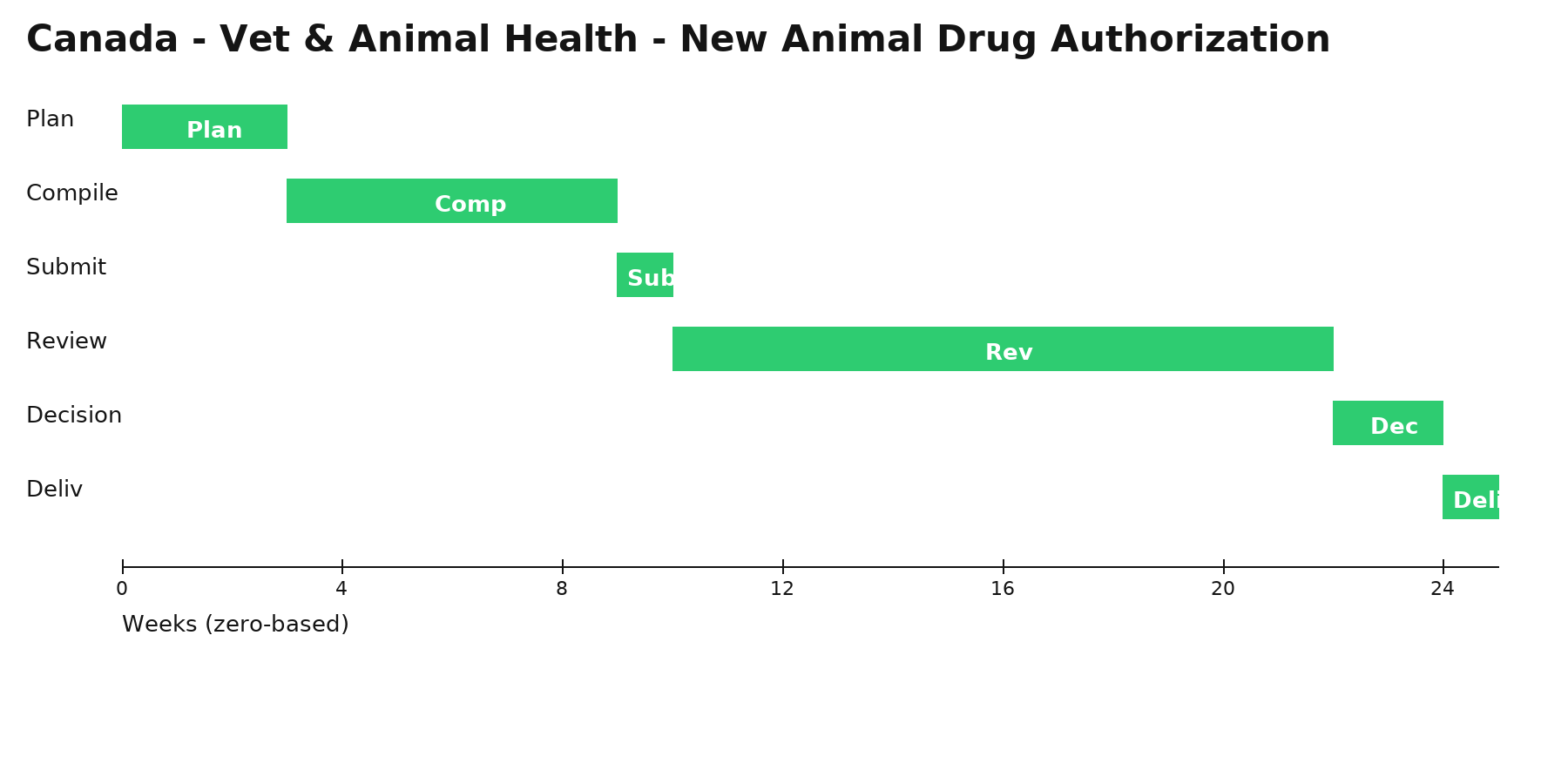

Gantt timeline

Phases & Tasks

Plan (3 wks) — Define pathway, reliance, local roles (MAH/agent); build high-level plan & risk register.

Compile (6 wks) — Assemble dossier/quality evidence; confirm translations, legalization/apostille, and samples/testing.

Submit (1 wk) — File via portal/gateway; complete fee payment and resolve validation issues.

Review (12 wks) — Manage queries/clock-stops; submit clarifications, addenda, or product samples as requested.

Decision (2 wks) — Receive authorization or additional requests; align launch, PV, and supply readiness.

Deliv (1 wk) — Issue internal release pack (certificates, approved labels, SOPs) and plan for renewals/variations.

Deliverables

  • Authorization/Certificate or Registration Record
  • Approved labeling/artwork (as applicable)
  • Final dossier, correspondence log, and post‑approval plan
